Overview
Use Schedules to plan your project and keep track of it on a timeline. Use dependencies to automatically reschedule your project based on changes and visualise the critical path to be aware of the phases and tickets determining the project end date.
Key benefits of Schedules integrated into PlanRadar:
-
Works similar to popular project management tools such as Microsoft Project
-
Access your schedule onsite using our mobile apps
-
Fully collaborative: let other in-house users view or edit your schedules
-
Integrated with tickets: track progress on the project level including tickets’ progress
Access & permissions
Schedules is available to Pro and Enterprise accounts. Read more in Pricing and Subscription.
To view schedules you need a watcher or an in-house user with a role permission to view schedules.
To create or edit schedules (only in the Webapp) you need an in-house user with a role permission to manage schedules.
Subcontractors don't have access to schedules. Read more in User Types and Permissions.
You can request a trial by contacting support at support@planradar.com if you are on a Basic or Starter plan.
In this article, the Schedules feature is explained for the Webapp. However, it is accessible from the mobile apps.
General Concept
A schedule outlines a project as a sequence of project phases that typically depend on each other. With Schedules, PlanRadar supports two popular project management concepts:
Work Breakdown Structure (WBS): phases can be divided into sub-phases to summarise parts of the project and keep the overview. They can be collapsed and expanded to drill down into more detailed planning.
Gantt Chart: phases (and optionally tickets) are visualised as bars on a timeline which is synced in real-time with the WBS. It is possible to reschedule phases automatically – read more below in Manual vs. Automatic Scheduling.
Read more in View & Navigate a Schedule.
Each project can have only one schedule.
Schedules are limited to a maximum of 8 levels of sub-phases and 2,000 phases or tickets per schedule/project.
Schedule Start Date
Each schedule requires a start date. It is the earliest possible day a phase or ticket can start. Unlike other tools like Microsoft Project, PlanRadar does not allow to let phases or tickets start before the schedule start date.
The start date must be set before the first phase can be created.
Read more in Set or Change the Schedule Start Date.
Phases & Tickets
Phases and sub-phases are the basic building blocks of Schedules.
Tickets of any form can be added to the schedule below a phase and they can also have optional start dates, end dates and duration.
Phases

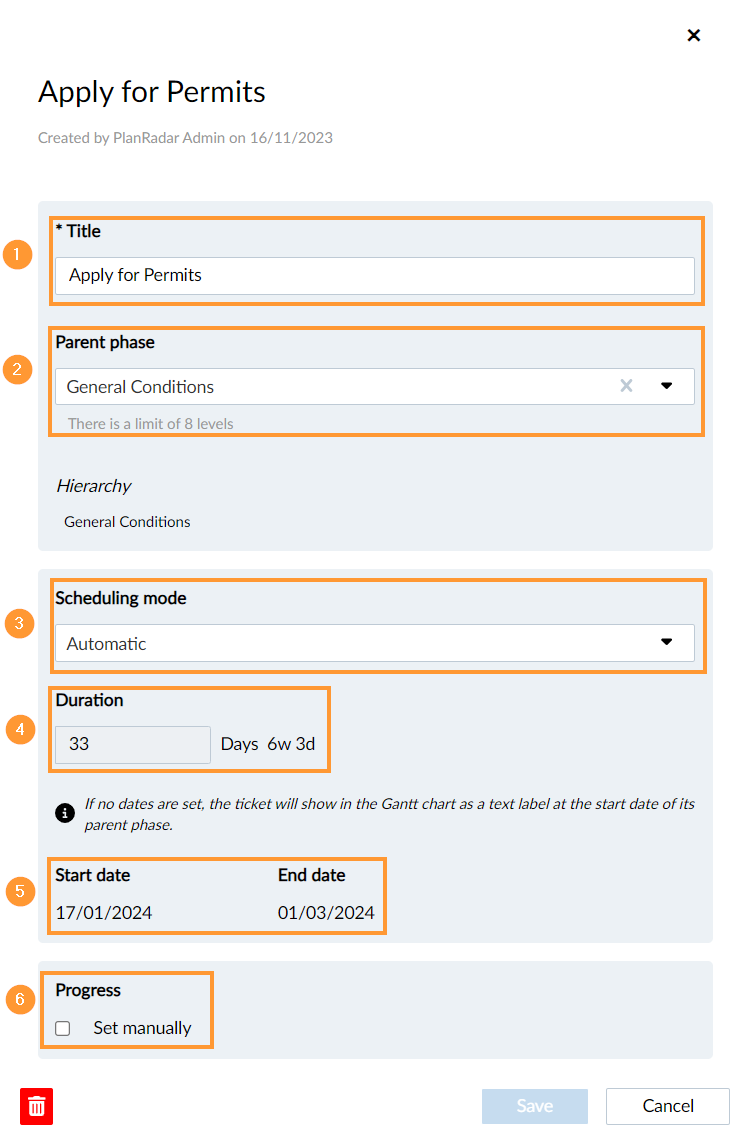

Phases consist of:
- Title is the only mandatory field.
- Parent phase is optional and used to define the hierarchy of phases and sub-phases.
- Scheduling mode defines whether you want to set dates manually or let PlanRadar auto-schedule. It is set to Automatic by default.
- Duration in working days (optional; non-editable and calculated in case of automatically scheduled phases with sub-elements).
- Start date & end date can be optionally set in case of manually scheduled phases/tickets. In automatic scheduling mode they are calculated.
- Progress is calculated from sub-elements (phases and tickets) by default or set manually.
Read more in Create, Edit or Delete a Phase.
Tickets
Tickets can be added to a schedule phase either with or without duration and schedule dates. Tickets have the same fields like phases with the following differences:
- The parent phase is mandatory.
- Tickets cannot have sub-elements (i.e. they are leaf-nodes in the hierarchy).
- The progress is always calculated from the ticket progress and/or status fields. Read more below in Progress.
Sub-tickets are not shown in the schedule.
Read more in Create, Add or Remove Tickets from Schedules.
Duration, Start Date & End Date
PlanRadar ensures that the duration, start date and end date stay consistent.
If two of them are specified manually, the third one is calculated automatically:
- A change of duration updates end date.
- A change of end date updates duration.
- A change of start date updates end date.
The duration, start date and end date are optional. This way it is possible to create a WBS first before setting durations and arranging them on the timeline. And sometimes you might want to add tickets without schedule dates, just to track their progress.
Phases and tickets without a duration are still visualised in the Gantt chart:
- If no duration but start date is set (or calculated in case of automatic scheduling), a title label will be shown in the chart at the start date instead of a bar.
- If no duration and dates are set at all (which is only possible with manual scheduling), a title label will be shown in the chart at the start date of the closest parent in the WBS hierarchy.
Each day is counted for the duration, e.g. if a phase starts and ends on the same day it has a duration of 1 day.
Progress

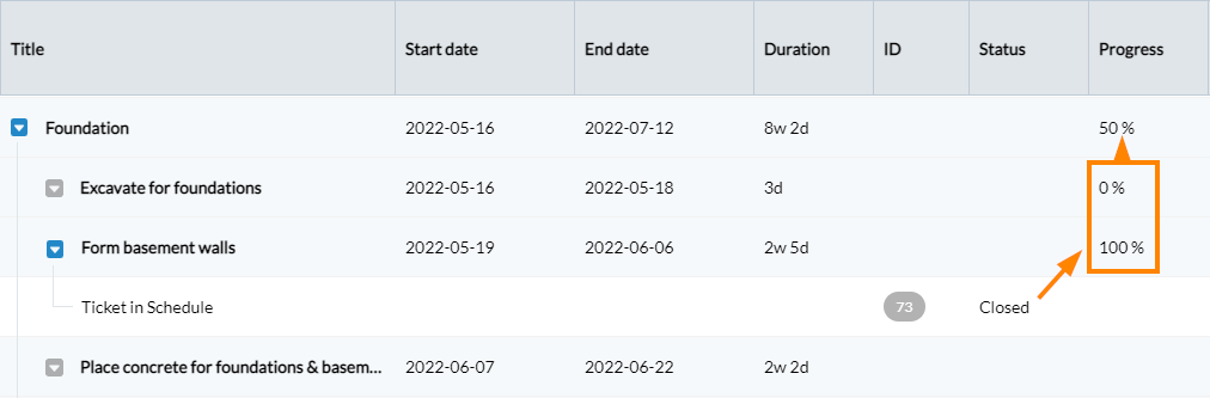

The progress of a phase can be set manually or calculated automatically based on its sub-elements (phases/tickets).
Phases that have neither a manually set nor a calculated progress (which can happen if there are no items with such information below), are ignored when calculating the progress of their parent.
The progress of a ticket is calculated based on existing status and progress fields in the form.
Tickets with no such fields are ignored when calculating the progress of their parent phase.
Ticket has status field only

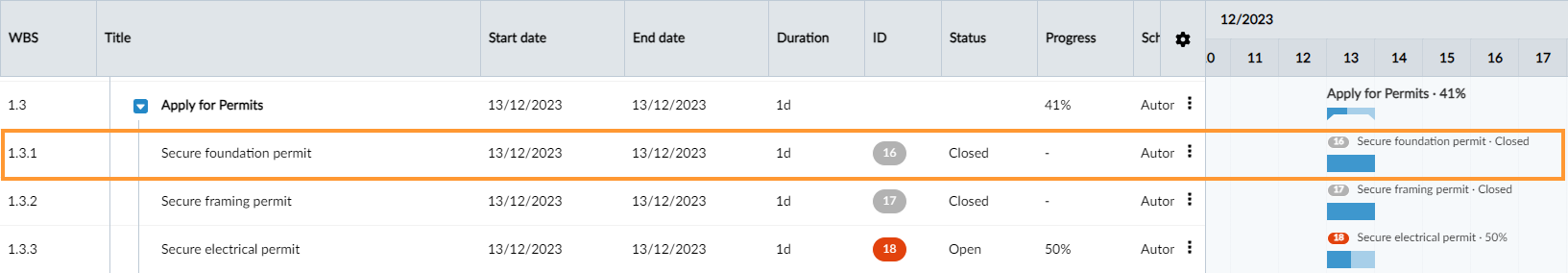

If status is "Closed" the progress in the schedule is assumed as 100% for further calculation. No progress value is shown in the table and Gantt chart in this case.
Ticket has progress and status fields
If status is "Closed" the progress in the schedule is assumed as 100% for further calculation and the ticket's progress value is ignored.
Otherwise the value of the ticket progress is used for further calculation in the schedule and the progress value is shown in the table and Gantt chart.
Ticket has progress field only
The value of the ticket progress is used for further calculation in the schedule and the progress value is shown in the table and Gantt chart.
Overdue
Overdue tickets and phases are highlighted.

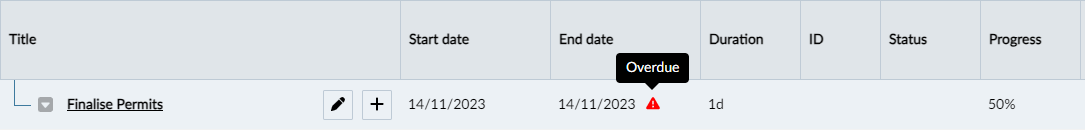

Tickets are overdue if their status is not 'Closed' yet and the end date or due date is in the past.
Phases are overdue if their progress is not 100% and the end date is in the past.
Manual vs. Automatic Scheduling
Phases and tickets have a scheduling mode.
Use Manual mode if you want to control when a phase/ticket should start. The start date will then never change, even if there are dependencies. It is as if the phase/ticket is pinned to the timeline.
If a manually scheduled phase/ticket has a predecessor and its start or end date changes (e.g. a phase gets delayed), dependency issues can occur if the phase/ticket would need to start earlier or later than the manually set start/end date. Read more in Resolve Scheduling Conflicts.
Manually scheduled phases with sub-elements will never automatically entail all of their sub-elements as their start/end dates are set manually.
Use Automatic if your project will face changes and you want to benefit from automatic rescheduling of all the phases and tickets in your project. PlanRadar will determine the start date based on the general As-Soon-As-Possible (ASAP) rule while also considering:

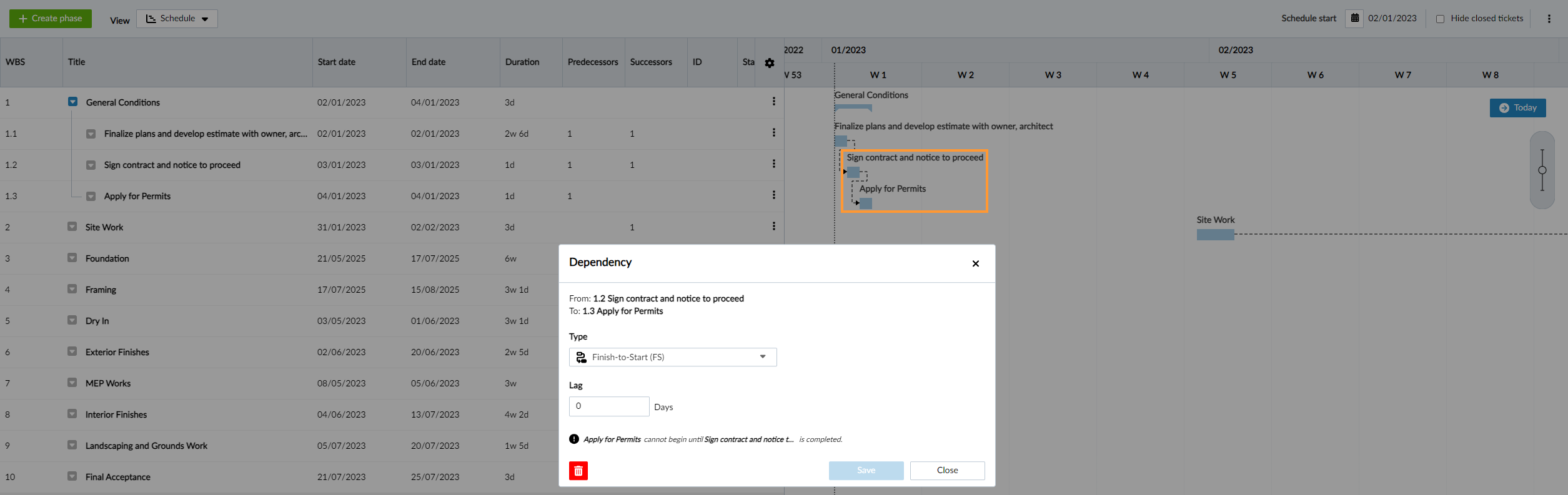

- Dependencies – read more in Create, Edit or Delete Dependencies.
- Schedule start date
- Working days (if configured)
- Parent phases
We recommend keeping the default Automatic scheduling mode and using dependencies.
PlanRadar supports four dependency types:
- Finish-to-Start
- Start-to-Start
- Finish-to-Finish
- Start-to-Finish
Each phase/ticket can have up to 10 dependencies.
Read more in Create, Edit or Delete Dependencies.
Additional Features
Working Days
Working days is a project setting which allows you to define on which week days the project team will be working. It also allows you to select a holiday calendar for all countries and regions of the world.
If configured, it will impact your schedule and duration calculation will be based on working days not week days. For instance, a 5-day task starting on Thursday will end on Wednesday the week after if Saturday/Sunday is a weekend. Working days are also indicated in date pickers.
Read more in Configure Working Days.
Import & Export Schedules
Currently you can import and export a schedule from/to Microsoft Project and import from Asta Powerproject and Primavera P6 - read more in Import & Export a Schedule from/to Microsoft Project and Other Software.
It is also possible to Export Schedule as PDF.
